Retail Shop Reinstatement in Singapore: A Complete Process Breakdown

Why “Packing Up and Leaving” Is Not Retail Reinstatement

What Retail Tenants Assume vs What Landlords Actually Require

Most retail tenants budget two weeks and a removal truck for their move-out. Then they receive the reinstatement schedule. It lists 40 individual scope items covering the removal of ceiling systems, ACMV (air conditioning, mechanical, and ventilation) additions, electrical installations, signage structures, specialist flooring, and partitions, and the restoration of every affected surface to a defined shell condition. None of this was part of the plan.

This expectation gap is the most expensive mistake retail tenants in Singapore make, and it is almost entirely avoidable.

The Cost of Getting Reinstatement Wrong: Security Deposit and Beyond

When the scope is incomplete at the handover inspection, the landlord engages their own contractors to finish the outstanding works and charges the cost directly against the security deposit at commercial rates. What a tenant’s contractor would have completed for $15,000 becomes $35,000 in landlord-arranged rectification.

The second cost is holding. A tenant who cannot complete the works before lease expiry pays daily rent, often at a penalty rate, until the landlord accepts handover. Two weeks of holding costs on a mid-size Orchard Road unit can eliminate whatever remains of the security deposit.

What Is Retail Shop Reinstatement?

The Legal Basis for Reinstatement in a Singapore Retail Lease

Reinstatement obligations are embedded in commercial tenancy agreements from the date of signing. The lease specifies that the tenant must return the premises to the condition in which it was received, which, in practice, means the shell condition documented at the original handover. This obligation cannot be negotiated away at lease expiry.

What “Restoring to Original Condition” Actually Means for a Retail Space

Shell condition in Singapore’s retail context means the bare, unfinished space as it was handed over before any tenant fit-out. For some mall landlords, this means exposed concrete with basic electrical stub-outs. For others, it means painted walls with a suspended ceiling grid but no tiles. The definition is specific to each tenancy and is found in the original handover documentation, not in a general standard.

How Retail Reinstatement Differs from Office or Industrial Reinstatement

Retail fit-outs involve more mechanical, electrical, and ACMV modifications than office fit-outs. Mall management adds a compliance layer that does not exist in standalone office buildings: contractor approval processes, ACMV coordination with the building’s maintenance contractor, and facade protocols requiring formal sign-off.

Who Is Responsible for Reinstatement: Tenant, Landlord, or Contractor?

The tenant is responsible. Not the contractor who performed the fit-out. Not the contractor performing the works. When the landlord’s inspector identifies an incomplete scope, the notice goes to the tenant. Delegating the compliance check entirely to the reinstatement contractor without independent verification transfers the work but not the risk.

The Reinstatement Schedule: Your Most Important Document

What a Reinstatement Schedule Is and When Landlords Issue It

The reinstatement schedule is the formal document specifying every element that must be removed and every surface that must be restored. It is typically issued three to six months before lease expiry, but can arrive as late as 4 to 6 weeks before. Requesting it before formal issuance is one of the most effective ways to create usable project lead time.

How to Read and Interpret a Mall or Landlord’s Reinstatement Schedule

Map every line item against the current physical condition of the unit, zone by zone. The most commonly misunderstood items are ACMV removal requirements, reinstatement of the original distribution board (DB board), and the distinction between “remove” and “make good.” Remove means full physical extraction. Make good means restoring the affected surface to the defined standard after removal, including patching, levelling, and preparation.

When a schedule item is ambiguous, seek written clarification from the landlord’s representative before any work begins.

What to Do If the Schedule Is Issued Too Close to Your Lease Expiry Date

If the schedule arrives with less than four weeks before expiry, options include requesting a short lease extension at daily rent, negotiating a phased handover, or mobilising multiple contractors simultaneously. Document the late issuance in writing. It may become relevant in a deposit dispute.

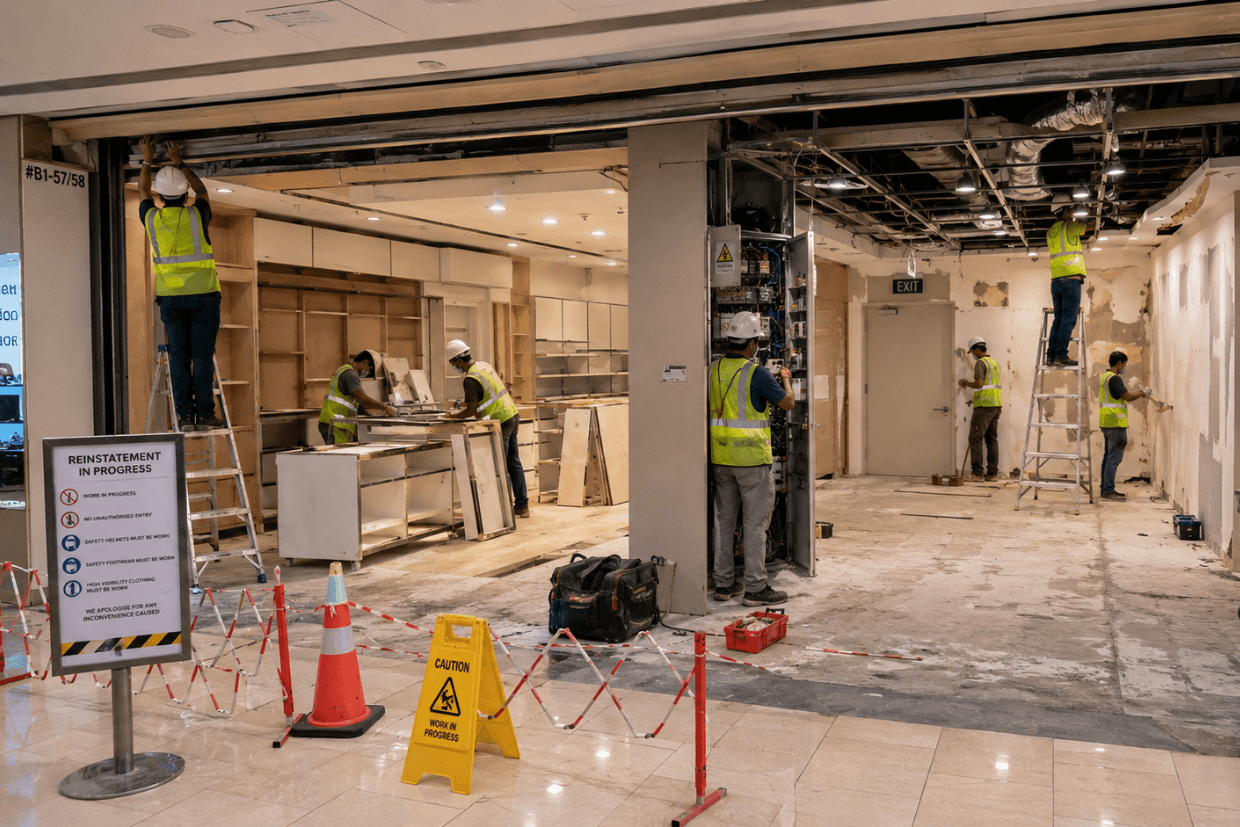

The Full Scope of Retail Shop Reinstatement Works

Category 1: Removals – What Must Come Out

Fixtures, Fittings, Display Systems, and Shelving

All tenant-installed shelving, display cases, counters, and point-of-sale structures must be removed in full, including anchor bolts, fixings, and floor or wall penetrations created for installation.

Partitions, Feature Walls, and Ceiling Systems

Non-structural partitions, drywall, glass partitions, feature walls, suspended ceiling systems, bulkheads, and light boxes installed over the original ceiling structure must be fully removed.

Electrical Installations, Lighting, and Data Points

All tenant-installed electrical fittings, tracks, sub-mains, and data points must be removed back to the original stub-out. An EMA-licensed electrical worker must certify the electrical work, and documentation must be submitted to the landlord.

ACMV Additions: Air Conditioning, Mechanical, and Ventilation Works

The scope item most consistently missed is ACMV removal, and it is the costliest gap in the reinstatement scope. It covers all tenant-installed fan-coil units, duct modifications, grille additions, and connections to the base-building system. ACMV removal in a managed mall environment requires coordination with the building’s maintenance contractor and cannot be accelerated once the coordination process begins.

Signage, Branding Elements, and Fascia Boards

Full removal means not just the sign face but the mounting box, structural frame, cabling, and all facade penetrations, made good to the original surface condition.

Specialised Flooring and Floor Coatings

Where the original floor was bare screed, tenant-installed flooring must be removed and the screed reinstated to the original level. Confirm this against the handover documentation before proceeding.

Category 2: Restoration – What Must Be Brought Back

Restoring Walls, Ceilings, and Floors to Shell Condition

Making good means more than patching holes. Walls must be ready to receive a new finish. Ceiling structures must be restored to their original configuration. Floor levels must match the defined handover standard.

Reinstating Original Electrical Supply Points

The DB board and supply points must be returned to the configuration specified in the original handover documentation, not to a general standard.

Patching, Making Good, and Surface Preparation

Making good is a defined scope item. Filler applied over penetrations without proper surface preparation is routinely rejected at handover inspection.

Works That May Require PE Endorsement or Authority Approval

Structural modifications made during the fit-out may require a Professional Engineer endorsement from the Building and Construction Authority before removal. Works affecting fire safety systems may require SCDF coordination. Identify these requirements during the schedule review stage, not during work execution.

The Retail Reinstatement Process: Step by Step



Step 1: Obtain and review the schedule. Map it against the current fit-out and identify all ambiguities in writing before engaging contractors.

Step 2: Engage a certified contractor with building access clearance. Confirm the contractor holds the bizSAFE certification level required by the mall.

Step 3: Conduct a joint site inspection with the landlord. Document agreed scope interpretations in writing.

Step 4: Execute works in sequence: ACMV and electrical works first, structural removal second, cosmetic making good last.

Step 5: Self-audit against every schedule line item before requesting the final handover inspection.

Step 6: Respond to snagging notices within the timeframe specified. Missed deadlines result in the landlord arranging completion at the tenant’s cost.

Step 7: Confirm the deposit release process, required documentation, and processing timeline after a clean final inspection.

Timeline and Costs: What to Realistically Plan For

How Far in Advance Should You Start the Reinstatement Process?

Six to eight weeks minimum before lease expiry for a standard retail unit. Contractor engagement alone requires two to four weeks of lead time before work can commence.

How Long Does Retail Shop Reinstatement Typically Take?

Duration depends on unit size, fit-out complexity, and ACMV coordination. The table below provides indicative estimates.

Unit Size

Typical Duration

Approximate Cost Range

Key Variable

Small retail (under 200 sqft)

1 to 2 weeks

$8,000 to $20,000

Fit-out complexity

Mid-size retail (200 to 500 sqft)

2 to 3 weeks

$20,000 to $50,000

ACMV scope

Large-format retail (500 sqft and above)

3 to 6 weeks

$50,000 and above

Structural modifications

Note: Figures are approximate, indicative ranges. Actual costs vary based on fit-out complexity, ACMV scope, and specific mall management requirements.

What Causes Reinstatement Projects to Run Over Time or Budget?

Late schedule issuance, ACMV coordination delays, and missed scope items discovered mid-works are the three consistent causes. All three are addressable through early schedule review, pre-work ACMV verification, and a full-scope map before work begins.

Contractor Requirements for Retail Reinstatement in Singapore

Why Building Management Often Requires Specific Contractor Certifications

Mall management in Singapore typically requires contractors to hold a minimum BizSAFE Level 3 certification before granting access. A competitive quotation from a contractor without the required level is not usable, regardless of price.

bizSAFE Certification: What It Is and Why It Matters for Commercial Buildings

bizSAFE Level 3 means the contractor has an independently assessed Risk Management Plan in place. Most Singapore commercial buildings require a minimum of Level 3 for any contractor accessing the premises. Verify current certification status through the WSH Council registry before engagement.

What to Check Before Engaging a Reinstatement Contractor

Four checks before signing: current bizSAFE certification, proven fit-out removal experience in similar managed environments, capacity to coordinate ACMV and electrical specialists, and their documentation process for completed scope items.

Why Using a Contractor Without Mall Access Clearance Causes Delays

Mall management rejects access applications from uncertified contractors. When this occurs after the contractor is engaged, work cannot start, and the tenancy clock continues. Verify access eligibility before appointment.

Common Retail Reinstatement Mistakes and How to Avoid Them

Underestimating the Scope of the Reinstatement Schedule

Count schedule line items, not visible fittings. Many items are not visible during a walkthrough: sub-ceiling ACMV connections, sub-floor drainage modifications, and electrical changes made inside walls.

Missing ACMV and Mechanical Services Removal Requirements

Confirm all ACMV items in the schedule with the building’s maintenance contractor before work begins. They will identify what was added and what the base building restoration requires.

Starting Too Late and Running Into Lease Expiry

Six to eight weeks minimum before expiry is the safe threshold. A compressed works programme leads to a failed inspection, which leads to an extended tenancy at penalty rate.

Failing the Final Handover Inspection and Its Cost Consequences

Self-audit every schedule item before calling for inspection. Items not resolved within the snagging deadline are completed by the landlord’s contractor at the tenant’s cost.

Assuming Certain Elements Are Excluded Without Confirmation

The standard is the original handover condition for this specific tenancy. Get written confirmation from the landlord before leaving any element in place.

How to Start Your Retail Shop Reinstatement in Singapore

Request the Reinstatement Schedule From Your Landlord Now

Contact the landlord or mall management immediately. Request the original handover documentation and any fit-out approval drawings from the start of your tenancy alongside the formal schedule.

What to Look for When Engaging a Retail Reinstatement Contractor

Three non-negotiables: bizSAFE certification at the level required by the building, proven experience in removing retail fit-out in managed mall environments, and the ability to coordinate specialist ACMV and electrical sub-contractors.

Questions to Ask Before Signing a Reinstatement Contract

Does your quotation cover every line item on the attached schedule? What is explicitly excluded and why? Who manages ACMV coordination with the base building contractor? What documentation do you provide upon completion of each scope item?

Singapore Demolition Hackers N Removals is one example of a bizSAFE-certified contractor in Singapore that operates across commercial retail reinstatement projects, covering the scope from schedule review through final handover documentation.

Conclusion

Retail shop reinstatement in Singapore requires the full removal of all tenant-installed elements and the restoration of the space to its original shell condition. The scope is defined by the landlord’s schedule, not by what the tenant considers removable. The five decisions that determine whether the project succeeds are: obtaining the schedule early, engaging a certified contractor with building access clearance, conducting a pre-works joint inspection, self-auditing before calling for final handover, and addressing snagging notices within their deadlines. Starting at least six to eight weeks before lease expiry and treating the reinstatement schedule as the authoritative scope document are the foundations of every successful retail handover in Singapore.
