Office Reinstatement Cost in Singapore: What Affects the Price by Fit-Out Type

Why the Cost Per Square Foot Figure Is Misleading Most Office Tenants

What Office Tenants Are Told vs What Actually Determines Cost

Search for “office reinstatement cost Singapore”, and you will find figures like “$15 to $80 per sqft depending on fit-out.” This range provides no usable planning information. An office sitting anywhere between $45,000 and $240,000 is not a budget figure. It is an admission that the metric is wrong.

What Office Reinstatement Cost Actually Depends On

The price is driven by what was installed and by the landlord’s reinstatement schedule for what must be removed. Floor area is almost irrelevant. The schedule determines which trades are required, how long each will take, and what specialist sub-contractors must be engaged.

Why Two Identical-Size Offices Can Cost Very Different Amounts to Reinstate

A 3,000 sqft office with standard drywall partitions, a basic ceiling system, and minimal electrical modifications has a very different scope from one fitted with floor-to-ceiling glass partitions, raised access flooring, a server room, and extensive ACMV modifications. The floor area is the same. The scope is not. The second costs approximately four to five times more to reinstate. The floor area explains none of the difference.

What Drives Office Reinstatement Cost: The Six Key Variables

Variable 1: The Reinstatement Schedule Scope

The landlord’s reinstatement schedule is the primary cost document. It specifies every element to be removed and every surface to be restored. Requesting it as early as possible, rather than waiting for formal issuance, creates accurate planning time.

Variable 2: Fit-Out Construction Type

The materials and construction methods used in the original fit-out determine removal complexity. Drywall partitions cost less to remove than glass partitions. Glass partitions cost less than floor-to-ceiling demountable systems with integrated electrical. Each type requires different labour, equipment, and disposal.

Variable 3: Mechanical and Electrical Scope

M&E restoration covers three distinct scopes: removing electrical modifications back to the original distribution point, restoring the distribution board (DB board) configuration, and returning ACMV (air conditioning, mechanical, and ventilation) systems to their pre-tenancy state. Each requires licensed specialists. All three require coordination with the base building maintenance team.

Variable 4: Raised Flooring and Specialist Floor Systems

Raised access flooring, common in technology and financial sector offices, costs significantly more to remove per sqm than standard flooring because each panel and pedestal must be individually extracted, the sub-floor must be assessed and restored, and the material volume for disposal is substantially higher.

Variable 5: Disposal Volume and Building Access Conditions

NEA regulations require construction waste to be disposed of through licensed contractors, charged by weight and trip. High-specification fit-outs generate far more waste volume than basic ones. CBD commercial buildings impose access fees, goods-lift restrictions, and limited working hours, all of which increase the total project spend.

Variable 6: Timeline Pressure and Programme Duration

A compressed timeline increases the price. When multiple trades work simultaneously to meet a lease expiry date, overtime rates apply, more supervision is required, and more access days must be booked in parallel. A six-week programme at standard rates consistently costs less than a two-week accelerated programme for the same scope.

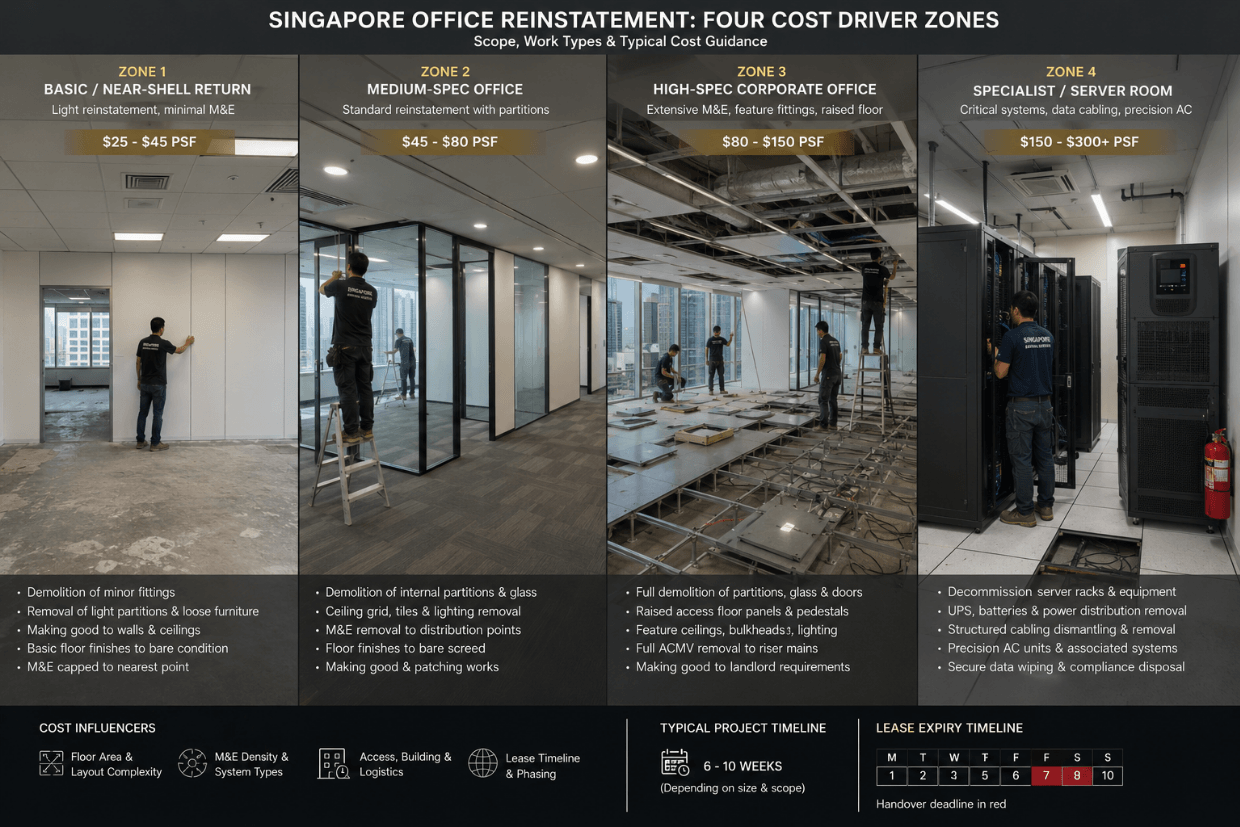

Office Reinstatement Cost by Fit-Out Type

The table below provides indicative cost ranges by fit-out type for a 3,000 sqft office in Singapore. Actual figures depend on the specific schedule and site conditions.

Fit-Out Type

Indicative Cost Range

Typical Duration

Primary Cost Drivers

Basic or near-shell return

$15,000 to $40,000

1 to 2 weeks

Light partitions, surface making good

Standard medium specification

$40,000 to $100,000

2 to 4 weeks

Glass partitions, M&E modifications, and ceiling

High-specification full fit-out

$100,000 to $220,000+

3 to 6 weeks

Raised flooring, full M&E, glass, specialist disposal

Server room or specialist use

Add $50,000 to $150,000+

2 to 4 weeks additional

Specialist decommissioning, licensed sub-contractors

Type 1: Basic Reinstatement (Near-Shell Return With Minimal Fit-Out)

What Basic Reinstatement Typically Involves

Offices with simple drywall partitioning, standard suspended ceiling, basic electrical modifications, and no raised flooring. The scope typically includes: removing partitions, restoring the ceiling grid, returning electrical points to their original configuration, and making good all surfaces.

Indicative Cost Range and What It Includes

The indicative range for a 3,000 sq ft basic office is $15,000 to $40,000. This includes labour, basic disposal, surface preparation, and electrical sign-off. Building access fees and specialist sub-contractor works are generally excluded and should be confirmed explicitly.

Type 2: Standard Office Reinstatement (Medium-Specification Fit-Out)

What Medium-Spec Offices Typically Include

The most common type in Singapore’s commercial market: a mix of drywall and glass partitions, custom ceiling layout, upgraded lighting, and a reception area. The scope is more complex because it involves multiple partition types, more electrical sub-circuits, and more surface area requiring making good.

Indicative Cost Range and Key Cost Drivers at This Level

The indicative range for a 3,000 sq ft medium-spec unit is $40,000 to $100,000. The elements that push toward the upper end are glass partition volume, extensive ceiling modifications, and the number of enclosed meeting rooms, each requiring a full envelope of removal and surface restoration.

Type 3: High-Specification Office Reinstatement (Full Corporate Fit-Out)

What High-Spec Fit-Outs Typically Include: Glass, Raised Flooring, Feature Ceilings

Financial services, technology, and professional services firms typically occupy this category. Characteristics include extensive glazed partitioning, raised access flooring across the tenancy, feature ceilings, ACMV modifications, custom joinery, and high-density electrical and data infrastructure.

Indicative Cost Range and What Makes This Category Expensive

The indicative range for a 3,000 sq ft high-spec unit is $100,000 to $220,000, or more. The three highest components are raised flooring removal, full M&E restoration, and glass disposal volume. Each involves specialist labour, licensing requirements, and disposal that do not scale with floor area.

Type 4: Data Centre, Server Room, and Specialist Use Reinstatement

Why Server Room Decommissioning Is Treated as a Specialist Scope

Decommissioning a tenant-installed server room involves specialist electrical work, removal of UPS systems and precision air conditioning, raised flooring in the server zone, structured cabling removal, and often fire suppression system deactivation. These works require specialist sub-contractors whose coordination adds time and spend beyond the standard project programme.

Indicative Cost Range and Specialist Requirements

Server room decommissioning typically adds $50,000 to $150,000 or more to the standard scope cost, depending on equipment installed and base building connection complexity. Identifying this scope early is essential to accurate planning.

Cost Breakdown by Work Type: What Each Element Typically Costs

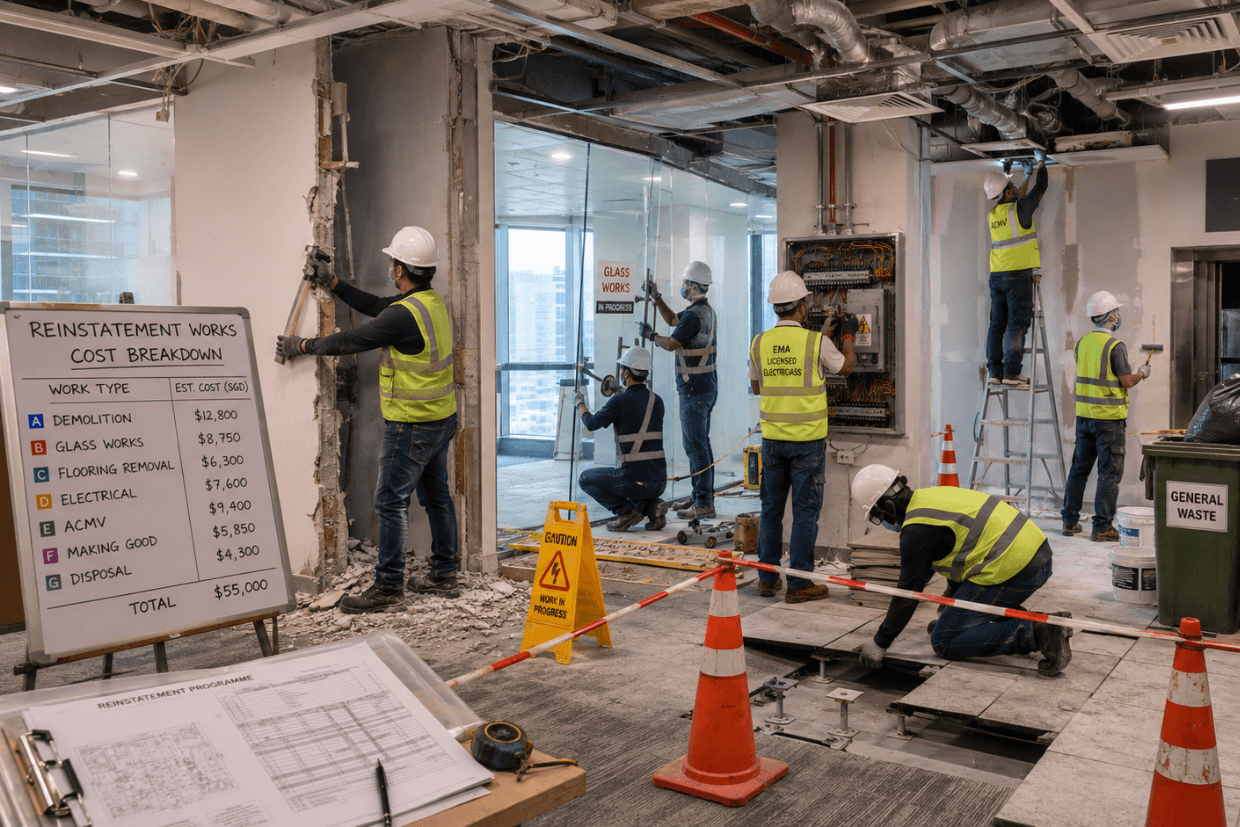

Hacking and Demolition Costs

Hacking works are priced by linear metre of partition or by area of floor or ceiling demolished. Concrete and masonry cost more to hack than lightweight drywall. Dust containment in occupied adjacent spaces adds further to the bill.

Partition and Ceiling System Removal

Drywall removal is the least expensive partition type. Glass partition dismantling costs two to three times more per linear metre than drywall when labour and disposal are combined. Ceiling systems with custom tile layouts or feature elements cost more than standard suspended grid removal.

Raised Flooring Removal: What It Costs and Why

Raised access floor removal is priced per panel and pedestal, not per sqm. Sub-floor restoration adds a further variable that may not be fully knowable until the panels are lifted. Budget for sub-floor making good as a contingency item.

Glass Partition Dismantling vs Drywall Removal

Glass partition dismantling costs two to three times more per linear metre than drywall removal. Glass disposal is classified as waste and must be handled by licensed contractors, adding a separate disposal line.

Mechanical and Electrical Restoration Costs

M&E restoration requires EMA-licensed electricians and produces documentary sign-off evidence for the landlord. ACMV restoration requires coordination with the base building maintenance contractor and cannot be accelerated once that process begins.

Making Good: What It Costs and What It Covers

Making good to a “paintable standard” is specified differently from “original condition.” The landlord’s schedule defines which applies. Underestimating the making-good standard is one of the most consistent causes of failed handover inspections.

Waste Disposal and Licensed Disposal Contractor Costs

Construction waste disposal follows NEA’s licensed contractor requirements. For a high-spec project, disposal can represent 15 to 25 %of the total project spend. Buildings that restrict trip frequency compound the disposal component significantly.

Hidden Costs That Inflate Office Reinstatement Bills

Building Management Levy and Access Fees

CBD commercial buildings charge contractors access fees, including daily rates, goods-lift bookings, and management coordination charges. These are frequently excluded from initial quotations. Request the building’s contractor access policy before issuing any scope.

Overtime and After-Hours Working Requirements

Noise-generating works and works on critical systems often require after-hours scheduling. After-hours rates for key trades typically run 1.4 to 1.8 times the standard rate. Identify whether your scope will require after-hours working before finalising the budget.

Works Requiring Licensed Specialists: Electrical, Structural, and ACMV

Certain works require separately licensed specialists whose rates and availability are outside a general contractor’s control. Ask each quotation to identify specialist works explicitly and state whether their costs are included or excluded.

Deficiency Notices and Landlord-Arranged Rectification Costs

Items not resolved within the snagging deadline are completed by the landlord’s contractor and charged to the tenant at commercial rates. A pre-handover self-audit against every schedule line item prevents most deficiency notice charges.

PE Endorsement When Required for Structural Works

A Professional Engineer endorsement from the Building and Construction Authority is required when the scope involves structural modifications. Identify whether your original fit-out included structural changes, as these almost always require PE endorsement for reversal.

How to Get an Accurate Office Reinstatement Quotation in Singapore

What to Provide to a Contractor for a Reliable Quotation

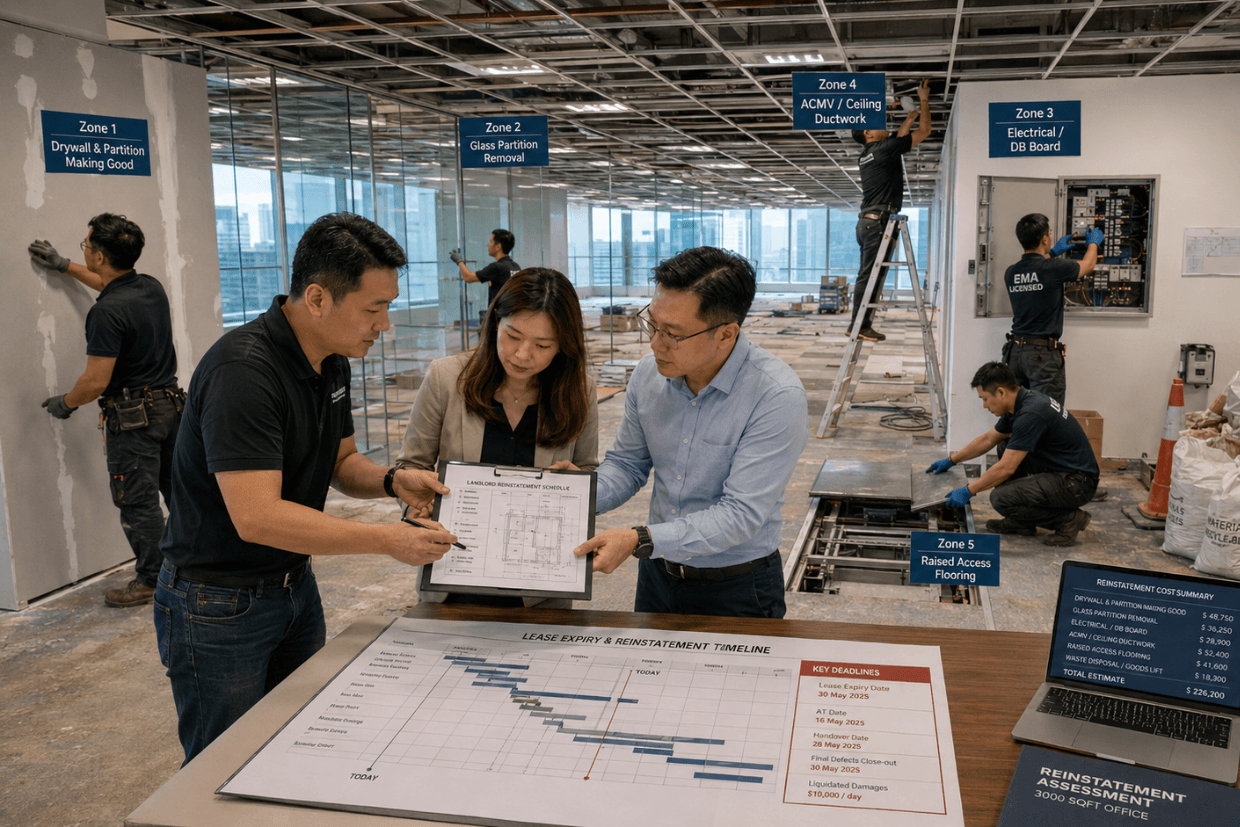

Five documents produce an accurate project quotation: the landlord’s reinstatement schedule, the current floor plan, original fit-out drawings, the building’s contractor access policy, and the remaining lease timeline. A quotation given without all five is an estimate, not a price.

What a Quotation Should Itemise: Red Flags and Green Flags

A well-structured quotation itemises by work category, states waste disposal as a separate line, explicitly includes or excludes access fees, identifies specialist sub-contractor works, and states a timeline. A lump-sum quotation with no breakdown, no waste disposal line, and no reference to electrical certification should prompt you to request a full itemised breakdown before proceeding.

Why Three Quotations at Different Prices May All Be Accurate

Three contractors looking at the same scope may quote $50,000, $85,000, and $130,000. Each may be accurate. Differences arise from different assumptions about access conditions, different interpretations of the making-good standard, and different inclusion or exclusion of specialist works. Request a scope confirmation meeting with each before selecting.

Singapore Demolition Hackers N Removals is a contractor with bizSAFE Level 3 certification that issues office project quotations mapped line by line to the landlord’s reinstatement schedule, with specialist sub-contractor scope and disposal presented as distinct items rather than absorbed into a lump sum.

How to Budget for Office Reinstatement as a Financial Obligation

When to Start Budgeting: How Far in Advance the Figure Should Appear

The project cost should be a provisioned line item in financial planning from the point when the fit-out scope is finalised, not a surprise at lease expiry. Update the provision when the reinstatement schedule is received.

What Contingency Percentage to Add and Why

Add 15-20% contingency to medium-spec projects and 20-30% to high-spec or specialist scopes. The contingency covers unknown sub-floor conditions, access overruns, and scope variations identified mid-works.

Whether Reinstatement Cost Can Be Negotiated With the Landlord

Negotiation is possible before lease expiry, not at handover. If the landlord wants to retain fit-out elements for the next tenant or if a new lease is being negotiated in the same premises, the standard lease obligation can be formally adjusted. Any agreed variation must be documented in writing before work begins.

Conclusion

Office reinstatement cost in Singapore is determined by fit-out type and complexity, not by floor area. Per-sq-ft rates are outputs of calculations, not planning tools. The six variables that drive the price are the reinstatement schedule scope, fit-out construction type, M&E depth, raised flooring systems, disposal and access conditions, and timeline pressure. Hidden charges, including building management levies, after-hours rates, and deficiency notice costs, are the most consistent cause of final bills exceeding quotations. An itemised quotation mapped directly to the landlord’s schedule, obtained with the five documents that allow accurate pricing, is the foundation of a reliable reinstatement budget in Singapore.
